Chapter 2
Expediting access:
Schedules 1 and 5 of the bill
Part IIIA of the Trade Practices Act 1974
2.1
Part IIIA of the TPA establishes the legislative framework for access to
services, provides consistency for access regulation and encourages economic efficiency
and promotes competition. The National Access Regime provides an avenue for
access seekers when an attempt at a commercial negotiation has failed.[1]
Section 44DA of Part IIIA 'requires decisions about access regimes to be
consistent with the principles set out in the Competition Principles Agreement'.[2]
2.2
Access seekers currently have three means by which they can make their
claim:
(a) Application through the National Competition Council (NCC) to have the
service provided by the infrastructure declared by the designated minister
and then access negotiated on a commercial basis;
(b) If agreement cannot be reached, the ACCC can make a legally binding arbitration.
(c) A minister's declaration or ACCC arbitration can be reviewed by
the Australian Competition Tribunal.
2.3
The role and powers of the three regulators, the NCC, ACCC and Tribunal,
under the amendments, will be explored in Chapter 5.
2.4
Seeking third party access is acknowledged to be a time-consuming
process, and delays to the decision-making process are recognised as being a
'significant concern to infrastructure owners, access seekers and regulators
alike'.[3]
In the interest of fostering competition in the Australian infrastructure
industry, the bill seeks to expedite decision making while maintaining the
thoroughness of the process.
Declaration of services
2.5
Through the declaration of a service, access seekers are provided with the
means by which they have a legal right to negotiate commercial terms and
conditions of access with the provider of the service.
2.6
The NCC may only recommend, and the minister implement, declaration when
the six criteria specified in the Act (Table 1) are all satisfied. In deciding
whether to recommend a declaration to the minister, the NCC conducts a public
consultation process, usually including a second round after release of a draft
recommendation. In addition to the declaration criteria, the NCC considers the
economic viability of development of a similar facility that could 'provide
part of the service... and the duration of any declaration'.[4]
Table 1: The six declaration
criteria
(a) that access (or increased access) to the service would promote a
material increase in competition in at least one market (whether or not in
Australia), other than the market for the service)
(b) that it would be uneconomical for anyone to develop another facility
to provide the service)
(c) that the facility is of national significance, having regard to:
(i) the size of the facility; or
(ii) the importance of the facility to constitutional trade or commerce; or
(iii) the importance of the facility to the national economy
(d) that access to the service can be provided without undue risk to human
health or safety
(e) that access to the service is not already the subject of an effective
access regime
(f) that access (or increased access) to the service would not be contrary
to the public interest
Sections 44G(2) and 44H(4) of the
TPA |
Source: National
Competition Council, Submission 5, p. 7.
2.7
Section 2.2 of the Explanatory Memorandum emphasises the meaning of
'declaration':
A person may apply for a service to be declared. Declaration
does not provide an automatic right for a third party to access that service.
Rather, it provides access seekers with a right to binding arbitration if
commercial negotiations cannot be successfully concluded.[5]
2.8
The NCC also makes clear in its submission to the inquiry that
declaration does not directly mean that access will be granted, and that the
function of Part IIIA is to consider the public interest in whether a service
should be declared.[6]
Declaration is also subject to commercial negotiations over the terms of
access. If the negotiations fail, the ACCC may provide arbitration.[7]
2.9
The decision by the NCC must be made within four months. The amendments
to time limits are discussed below.
2.10
The ACCC's arbitration is characterised by the NCC as 'light-handed' and
the ACCC is 'specifically prohibited from making an access arbitration
determination that would prevent an existing user having sufficient capacity to
meet its reasonably anticipated requirements'.
[8]
This is to aid in opportunities for commercial resolution of access disputes,
although the ACCC can make orders to resolve a dispute under the terms set out
in section 44X of the TPA.
2.11
As part of the arbitration process, s 44X1a states that the Commission
must take into account 'the legitimate business interests of the provider, and
the provider's investment in the facility.'[9]
2.12
Specific access regimes have been established for particular facilities
such as airports and natural gas pipelines. There may be certification of an
access regime established by a state or territory.
Binding Time Limits, Schedule 1
2.13
Schedule 1 of the bill seeks to increase efficiency through the
streamlining of administrative processes, the delay of which could hinder
potential infrastructure investment or deter potential access seekers from
making their claim.
2.14

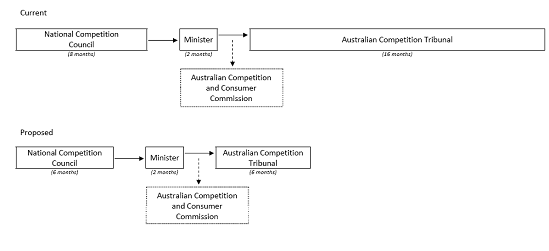

As illustrated in the upper panel of the following chart, and detailed
in Table 2, the experience with the processes has been that they can prove
very time‑consuming, particularly at the Tribunal stage. Even excluding
the epic Fortescue case as an outlier, the NCC has taken between 2 and 13
months, the minister has taken two months and the Tribunal between 6 and 32
months to reach decisions. The average total period for completed applications
is 26 months.
2.15
The bill will require the NCC, ACCC and Tribunal to take decisions
within specified periods, generally 180 days. Under the amendments, the NCC and
Tribunal may extend the period for making decisions, while the Minister can no
longer extend the period.
2.16
The minister will have 60 days to make a decision after receiving a
recommendation from the NCC, or will otherwise be deemed to have accepted the
NCC's recommendation.
2.17
The specified periods may be extended by 'clock stoppers'. The main
clock stoppers would occur when the regulator and the parties to the decision
agree to stop the clock, or when the regulator requests information or invites
public submissions.
2.18
Proposed section 44FA allows the NCC to request information within a
specified time period. Information received in that specified period must be
taken into account during the decision-making process.
Table 2: Time taken
for decisions on declaration applications under Part IIIA
Application |
NCC Recommendation |
Ministerial decision |
Tribunal Decision |
|
Date |
Date |
months taken |
Date |
months taken |
Date |
months taken |
Australian Union of Students |
April 1996 |
June 1996 |
2 |
August 1996 |
2 |
July 1997 |
11 |
Australian Cargo Terminal Operators (Sydney) |
Nov. 1996 |
May 1997 |
6 |
July 1997 |
2 |
Mar. 2000 |
32 |
Australian Cargo Terminal Operators (Melbourne) |
Nov. 1996 |
May 1997 |
6 |
July 1997 |
2 |
not appealed |
n.a. |
Carpentaria Transport |
Dec. 1996 |
June 1997 |
6 |
Aug. 1997 |
2 |
appeal withdrawn |
n.a. |
Specialized Container Transport |
Feb. 1997 |
June 1997 |
4 |
Aug. 1997 |
deemed decision |
appeal withdrawn |
n.a. |
NSW Minerals Council |
April 1997 |
Sept. 1997 |
5 |
Nov. 1997 |
deemed decision |
appeal withdrawn |
n.a. |
Specialized Container Transport |
July 1997 |
Nov. 1997 |
4 |
Jan. 1998 |
2 |
appeal withdrawn |
n.a. |
Freight Australia |
May 2001 |
Dec. 2001 |
7 |
Feb. 2002 |
2 |
appeal withdrawn |
n.a. |
Aulron Energy |
Nov. 2001 |
July 2002 |
8 |
Sept. 2002 |
2 |
March 2003 |
6 |
Virgin Blue Airlines Pty Ltd |
Oct. 2002 |
Nov. 2003 |
13 |
Jan. 2004 |
2 |
Dec. 2005 |
23 |
Services Sydney Pty Ltd |
Mar. 2004 |
Dec. 2004 |
9 |
Feb. 2005 |
deemed decision |
Dec. 2005 |
10 |
Fortescue Metals Group |
June 2004 |
March 2006 |
21 |
May 2006 |
deemed decision |
pending |
44*# |
Lakes R Us Pty Ltd |
Oct. 2004 |
Nov. 2005 |
13 |
Jan. 2005 |
2 |
appeal withdrawn |
n.a. |
Tasmanian Department of Infrastructure, Energy and Resources Rail
Unit |
May 2007 |
Aug. 2007 |
3 |
Oct. 2007 |
7 |
not appealed |
n.a. |
Pilbara Infrastructure Pty Ltd |
Nov. 2007 |
Aug. 2008 |
9 |
Oct. 2008 |
2 |
pending |
15* |
Pilbara Infrastructure Pty Ltd |
Nov. 2007 |
Aug. 2008 |
9 |
Oct. 2008 |
2 |
pending |
15* |
Pilbara Infrastructure Pty Ltd |
Jan. 2008 |
Aug. 2008 |
7 |
Oct. 2008 |
2 |
pending |
15* |
Average |
|
|
8 |
|
2 |
|
16* |
*Where a Tribunal decision
remains pending, the figure indicates the time taken as at February 2010. These
figures are not included in the average. #The time taken for the
Tribunal review of the decision relating to the FMG application also includes
time taken for the Federal Court to consider an appeal on the NCC
jurisdictional decision. Source: Treasury, Answer to Questions on Notice, 5
February 2010.
Binding time limits for the NCC
2.19
The expected period for the decision to be delivered is 180 days of
consideration. As stated above in paragraph 2.17, clock stoppers generally
occur when an agreement between the regulators and parties is reached on it. A
full list of clock stoppers can be found at Appendix 3. The NCC clock stoppers
apply to agreement between the regulator and parties, and requests for information.
2.20
Additionally, the NCC may apply for an extension for their decision, in
which case it must, by notice in writing to the Minister, apply for the
extension and justify its application.
Binding time limits for the ACCC
and deemed decisions
2.21
The ACCC's expected period for access undertakings, industry codes and
arbitrations of access disputes is 180 days. Competitive tender processes are
subject to a 90 day binding time limit.
2.22
Clock stoppers apply in the following cases:
- An agreement is made between the ACCC and the relevant parties to
the application or dispute;
- The ACCC requests information from a person via a written notice
or direction under section 44ZG;
- The ACCC invites public submissions on an application;
- The ACCC defers an arbitration or an access dispute under
subsection 44ZZCB(4); or
- The ACCC defers arbitrating a dispute while a declaration is
under review by the Tribunal.[10]
2.23
If the ACCC does not make a decision on a competitive tender process
within the expected period it is deemed to have approved it for a period of 20
years after a 21 day lapse. The lapse allows for an application for review
to be made to the Tribunal.
2.24
In the instance of failure to make an arbitration determination, the
decision is deemed to be in favour of maintaining the status quo.[11]
2.25
With regard to decisions on access undertaking, if the ACCC does not
reach a decision it will be deemed not to have accepted the access undertaking.
Binding time limits for the
Tribunal
2.26
The expected period for the Tribunal to make a decision is 180 days.
Clock stoppers apply in the case of an agreement between regulators and
parties, requests for information from a person or from a regulator.
2.27
To obtain an extension the Tribunal must write to the designated
Minister and publish a notice in a national newspaper. It should be noted that
under proposed section 44ZZOA(11) failure on the part of the Tribunal to reach
a decision within the time limit or extend the consideration period 'does not
affect the validity of a decision made by the Tribunal...'[12]
Attitudes towards Schedule 1
Views of larger miners
2.28
The Minerals Council of Australia (MCA) is opposed to the whole idea of
an access regime, which they argue is a 'chill' or deterrent to firms investing
in infrastructure.[13]
They characterise the bill as 'tinkering' which will make matters worse.[14]
In particular they oppose restricting the scope of the merit reviews.
2.29
At the 5 February hearing the Minerals Council expressed the view that
the entirety of Part IIIA be reviewed, and in particular pointed to the ‘uncertainty
and confusion’[15]
around it, which could be made worse by the reforms proposed in the bill.
The climate of uncertainty and confusion around this section
of the act will not be remedied by the administrative reforms proposed in the
bill. Indeed, they stand to exacerbate the situation in proposing to expedite
the access regime by imposing mandatory and arbitrary time limits on the
Competition Council...[16]
2.30
One of the MCA's largest members, Rio Tinto, also strongly opposes
Schedule 1 of the bill and shares the concern that time limits will have a
negative effect on the decision.
Speeding up decision making is not the answer if doing so
increases the risk of a wrong decision and further investment in vital infrastructure
is thereby discouraged.[17]
2.31
In regards to the efficacy of streamlining the administrative system,
Rio Tinto expressed the view that:
... it must hurt if you are worried that it is going to
increase the chances of a bad decision. That is the thrust of the submission,
and that is we do not like part IIIA.[18]
2.32
Rio Tinto's submission to the inquiry summarised their opinion on
Schedule 1, stating that they are opposed to it and believe:
that it will further dampen enthusiasm to invest in
facilities, beyond the disincentives provided by the current provisions of Part
IIIA.[19]
2.33
At the hearing, Rio Tinto opined that the complexity of a case might be
overlooked in order to make a quick decision.
I think we would always prefer a process that is efficient... but
we would also always prefer a process where material was properly considered
and tested. We would think that would be more important, in a sense, than a
strict time limit. In general, we would also suggest that the total time that
this has taken seems an inordinate amount of time, but a huge amount of that
time has actually been taken up with definitional debates in courts, rather
than in the set processes that are set down.[20]
2.34
Fortescue Metals Group (FMG) applied for a declaration in June 2004 of
services by BHP‑Billiton's Mount Newman and Goldsworthy railway lines.
The NCC decided that the Goldsworthy line was part of a production process and
therefore could not be declared but that the Mount Newman line could be
declared. BHP appealed to the Federal Court against the latter decision.
2.35
In December 2009 the case was reported as being with the Tribunal with a
decision not expected until mid-2010, and then possibly appealed to the Federal
Court and even the High Court, taking the case into 2011.[21]
2.36
Fortescue Metals highlighted a number of concerns with the existing
access regime and the timescales in which it operates. At the hearing Mr. Tapp
acknowledged that the Fortescue and BHP Billiton case was an exceptional case
having taken six years to reach its final stages. Mr. Tapp referred to their
Robe application which will have taken approximately two and a half years to
complete which Fortescue felt better reflected an average case. However he
noted that 'that is still too long' and that Fortescue 'welcomes anything that
compresses the timescales'.[22]
2.37
Fortescue also raised the difficulties for an applicant in what they
deemed to be 'double jeopardy'. This refers to the fact that under the current
arrangements an applicant can proceed through the National Competition Council,
receive a declaration by the Minister and then still have to re-argue the case
in its entirety before the Tribunal. Mr Tapp explained:
I just think it is wrong that you go through the entire
National Competition Council process to arrive at a declaration and then the
whole lot is just thrown away and you start again with the Tribunal. By the
way, the Tribunal is a much more expensive process. In terms of going to the
National Competition Council, the cost to Fortescue would be measured in tens
or potentially hundreds of thousands of dollars. Most of the work was done in
house. As soon as we go to the tribunal it starts being measured in millions of
dollars, with massive expensive legal fees, which is simply not necessary. Keep
as much in the National Competition Council as you can so that small access
seekers who do not have the sort of bankroll that Fortescue was able to put to
this have a chance of getting access to infrastructure. Otherwise you are just
switching it off for any small applicant who simply cannot afford the legal
costs involved in trying to get access to infrastructure.[23]
Schedule 5 – Administrative Amendments
2.38
Schedule 5 of the bill proposes minor administrative amendments which
seek to streamline the process from the point of the regulators, the NCC, ACCC
and the Tribunal. Through these amendments the decision-making process will be
accelerated through the improving of efficiency frameworks.
2.39
The NCC will be able to make decisions via the circulation of papers to
the part-time councillors. The NCC will also be given the power to approve
variations to an application for declaration rather than requiring the
application be resubmitted. The repealing of criterion (d), seen in Table 1,
and the need to consider non-certified state access regimes is also intended to
aid in improving efficiency.[24]
2.40
The Tribunal will be given discretionary power over the staying of the
operation of a declaration decision during the review process, and ordering
costs in the review of declaration decisions.[25]
Committee view
2.41
In the consideration of access
given to third parties, expediting decision‑making would promote
competition and encourage smaller industry groups to use the legislation as it
was intended. The proposed amendments in Schedules 1 and 5 would aid in
achieving this, although the complexity of the cases should continue to be acknowledged.
Navigation: Previous Page | Contents | Next Page
